Grasp the quality, security, progress, create benefits!

Author:servicer Time:2022-06-28 13:12:06 Views:900

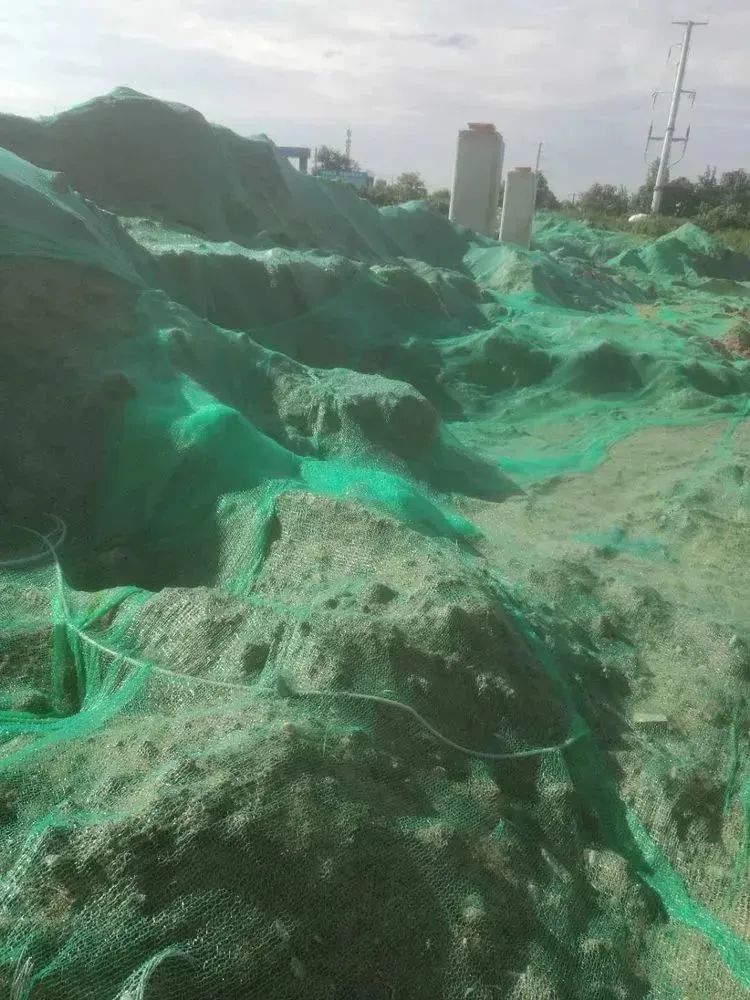

      Under the leadership of the leading group of the company and the efforts of all the staff of the Project Department, the Project Department of Fengdong New City, the second water supply engineering company of Xi'an, will thoroughly implement the company's ideological guidelines, and in the third quarter of 2022, in accordance with the company's work guidance objectives, the project department to Work Safety, improve quality as the focus of construction, strengthen management, change the concept, create high-quality brand engineering, lead the project staff, pioneering and innovative, grasp the quality, security, speed up progress, create benefits, to ensure the smooth implementation of the construction projects. In order to put the work of pollution control and haze reduction into practice, to further improve the working environment, and to ensure that the work of pollution control and haze reduction at the construction site achieves actual results, the ministry insisted on strict implementation of the six-hundred-percent and seven-point smog control requirements and standards, strengthened on-site management, regularly held regular meetings on dust control and smog control, and provided timely on-site training and guidance to workers, to ensure effective dust control and haze work. Third Quarter Fengdong New City Project Department work summary as follows:

1. The whole section of DN1200 water supply pipeline relocation project of Shangji Road (Fuyin expressway-xixian boundary) has been completed.

2. The whole section of DN400 Water Supply Pipeline Relocation Project of Bahe East Road has been completed.

3. The DN600 Water Supply Pipeline Relocation Project of Bahe East Road is 190 meters.

4. The 375-meter section of DN800 water supply pipeline in the north line of ketong No. 3(Planning Road to the west of Keyuan East road-keyuan East Road) has been completed.

5. the air route beyond the intersection breakpoint connection, pressure test, flushing has been completed.

6.202.225 m of DN400 water supply pipeline of Jianzhang No. 3(High Yield No. 3-high yield No. 3) has been completed. The pressure test of the pipeline has been completed.

7. Kunming Four Road (Fengdong Two Road [ Fenghe East Road ] ~ Fengjing Road) DN400 water supply pipeline, the completion of the pipeline pressure test, flushing work, data synchronization follow-up.

8. Fengchan Road B (Jianzhang Road 3-shang Navigation Road) DN600 water supply pipeline, complete connection, ready for pipeline pressure test, Flushing.

9. The flushing work of 5 kilometers of Section B, c and D of Fu Yu Road has been completed, and now the data are being perfected and signed. Among them, Bahe Road East ND600 Water Supply Pipeline relocation project, the design length of 303 meters, 190 meters has been completed, the remaining pipeline due to the existence of obstacles to suspend construction, construction work to be properly negotiated after the construction site.

      At the same time, although the construction period at this stage is tight, but the project quality, project safety, project progress never slacken, especially the key projects in the project, always want to urge the project quality, advance the project progress, give full play to their functions and improve the quality of the project.
